Dammed if they do

In pursuit of renewable energy, Indigenous Peoples of the Philippines are placed at risk of losing their ancestral lands

Video by LiCAS.news

Video by LiCAS.news

This is the first of a three-part investigative report on mega dam projects in the Philippines and their effects on the lives of Indigenous People.

As the United Nations Framework Convention on Climate Change (UNFCCC) prepares for its next Conference of Parties (COP), the Philippine government is set to report its progress in transitioning to renewable energy. But have they considered the social cost?

Two sisters, Monique and Princess, squealed with delight as they dashed toward the clear, cold waters of the Apayao River in Nacagman village, Kabugao town, in the northern Philippines, splashing in the shallows on a dry-season afternoon.

Unknown to the 9- and 7-year-old girls, the river, the valley they cherish, and the house they grew up in, just minutes away, will be submerged when a 94-meter dam is constructed on land their Isnag ancestors have called home for 10 generations.

The dam, known here as Gened-2, is one of the 427 hydropower projects awarded to private corporations all over the country as of February 2024. Of this number, 72 are already operating commercially while 355 are in various stages of project development, as part of the government’s shift to renewable energy sources.

On a hot summer day, Indigenous Isnag sisters, Monique, 9 years old, and Princess, 7 years old, enjoy the cold waters of the Apayao River, oblivious that a 94-meter dam will be built where they are swimming.

On a hot summer day, Indigenous Isnag sisters, Monique, 9 years old, and Princess, 7 years old, enjoy the cold waters of the Apayao River, oblivious that a 94-meter dam will be built where they are swimming.

Indigenous Isnag sisters, Monique, 9 years old, and Princess, 7 years old, run toward the river near their home to splash in the water, accompanied by their grandfather, Romeo Allong, their village’s pangat or elder.

Indigenous Isnag sisters, Monique, 9 years old, and Princess, 7 years old, run toward the river near their home to splash in the water, accompanied by their grandfather, Romeo Allong, their village’s pangat or elder.

On a hot summer day, Indigenous Isnag sisters, Monique, 9 years old, and Princess, 7 years old, enjoy the cold waters of the Apayao River, oblivious that a 94-meter dam will be built where they are swimming.

On a hot summer day, Indigenous Isnag sisters, Monique, 9 years old, and Princess, 7 years old, enjoy the cold waters of the Apayao River, oblivious that a 94-meter dam will be built where they are swimming.

On a hot summer day, Indigenous Isnag sisters, Monique, 9 years old, and Princess, 7 years old, enjoy the cold waters of the Apayao River, oblivious that a 94-meter dam will be built where they are swimming.

On a hot summer day, Indigenous Isnag sisters, Monique, 9 years old, and Princess, 7 years old, enjoy the cold waters of the Apayao River, oblivious that a 94-meter dam will be built where they are swimming.

Around one-third or 113 of these proposed hydropower projects will be built on ancestral lands, mostly in the northern Philippine Cordillera region.

The number excludes dams intended for water supply and irrigation like the New Centennial Water Source Project or Kaliwa Dam being built on ancestral lands of the Indigenous Dumagat-Remontado communities in the Southern Luzon region and the Jalaur River Multi-Purpose Project on the Indigenous Tumandok lands in the Panay region in central Philippines.

In the case of Gened-2, the Indigenous Isnag people will pay a steep price for accommodating the hydropower plant. Gened-2 will submerge Indigenous land, deprive the Isnags of livelihood, and destroy a UNESCO-declared biosphere reserve in the Cordilleras.

Because the Philippines’ power industry sector is privatized, although still highly regulated, the government has practically stepped aside in power generation, pulling all the stops to ensure that the projects get off the ground.

Department of Energy Assistant Secretary Mylene Capongcol browses through documents in her office in Taguig City in the Philippine capital region. Asec. Capongcol said that all private corporations and investors are welcome to bid for renewable energy projects. Photo by Chantal Eco

Department of Energy Assistant Secretary Mylene Capongcol browses through documents in her office in Taguig City in the Philippine capital region. Asec. Capongcol said that all private corporations and investors are welcome to bid for renewable energy projects. Photo by Chantal Eco

Let's remember that the power sector is now in the hands of the private sector when it comes to investments. The government is no longer investing in power generation projects.
Mylene Capongcol, Assistant Secretary of Department of Energy (DOE)

To further encourage the private sector to invest in renewable energy projects, the DOE initiated the Green Energy Auction Program (GEAP) that bids out potential energy resources to existing and new independent power producers.

Over 100 bidders won energy projects during the first and second Green Energy Auctions in 2022 and 2023, which are expected to install more than 5,000 MW of renewable energy.

DOE has already conducted its third round of auctions in August 2024 and is set to conduct its fourth round before the year ends. Based on the Philippine Energy Plan (PEP) for 2023-2050, the agency aims to install an additional 122.7 GW by 2050 to meet the country’s energy demands.

The country’s energy department and the Energy Regulatory Commission (ERC) are responsible for energy policy, including promoting private investment in renewable energy projects through the GEAP and market regulation. Meanwhile, the Department of Environment and Natural Resources (DENR) handles environmental compliance, while the National Commission on Indigenous Peoples (NCIP) is tasked with protecting Indigenous rights through the requirement of Free, Prior, and Informed Consent (FPIC) for any project that may affect Indigenous peoples' ancestral lands.

A view of Sitio Nacagman in Madatag village, Kabugao town. The small village in the northern Philippines will be wiped out if the Gened-2 dam is constructed. Photo by Chantal Eco

A view of Sitio Nacagman in Madatag village, Kabugao town. The small village in the northern Philippines will be wiped out if the Gened-2 dam is constructed. Photo by Chantal Eco

Pan Pacific’s Geneds

Gened-1, originally awarded as the 600MW Apayao-Abulog Hydroelectric Power Project, is one of the first of eight hydroelectric power plants awarded to Pan Pacific Renewable Power Phils. Corp. (PPRPPC), a wholly-owned subsidiary of the investment company FPSP (Holdings) Corp., lists businessman Francis C. Chua as the owner, according to Securities and Exchange Commission (SEC) documents.

Its President, Thunderbird Resorts and Casinos owner Allee Lourdes Sun, also sits on the board of FPSP (Holdings) Corp.

Thunderbird Pilipinas Hotels and Resorts owner Allee Lourdes Sun is the President of Pan Pacific Renewable Power Phils. Corp. (PPRPPC). She was also an executive at San Miguel Corporation affiliate Bank of Commerce. Photo from Allee Lourdes Sun’s Facebook account.

Thunderbird Pilipinas Hotels and Resorts owner Allee Lourdes Sun is the President of Pan Pacific Renewable Power Phils. Corp. (PPRPPC). She was also an executive at San Miguel Corporation affiliate Bank of Commerce. Photo from Allee Lourdes Sun’s Facebook account.

Chua is the current Chairman of the Bank of Commerce, an affiliate of San Miguel Corporation (SMC), and serves on the board of directors of the National Grid Corporation of the Philippines (NGCP), among other business affiliations. FPSP (Holdings) Corp. is not publicly known as one of Chua’s companies.

Francis C. Chua is the Chairman of Bank of Commerce, an affiliate of San Miguel Corporation. He owns FPSP (Holdings) Corp., which owns Pan Pacific Renewable Power Phils. Corp. (PPRPPC). Chua was instrumental in the implementation of China’s Belt and Road Initiative in the Philippines. Photo from 2GO Group

Francis C. Chua is the Chairman of Bank of Commerce, an affiliate of San Miguel Corporation. He owns FPSP (Holdings) Corp., which owns Pan Pacific Renewable Power Phils. Corp. (PPRPPC). Chua was instrumental in the implementation of China’s Belt and Road Initiative in the Philippines. Photo from 2GO Group

However, being both the owner of a power generation company and an official of the NGCP poses a conflict of interest. Section 45 of Republic Act No. 9136, or the Electric Power Industry Reform Act of 2001 (EPIRA), prohibits cross-ownership between power generation and distribution companies, and the state-owned National Transmission Corporation (TRANSCO), including its concessionaires. The NGCP, as TRANSCO’s concessionaire, operates the country’s power transmission network.

The Hydroelectric Power Projects (HEPP) by PPRPPC were among the several deals that then-president Rodrigo Duterte brought home from his first state visit to China in October 2016.

During that trip, Pan Pacific officials signed a Memorandum of Understanding (MOU) with Gao Yingxin, Vice President of the state-owned Bank of China (BOC), for a "bank-enterprise cooperation" at BOC's headquarters in Beijing, China. The agreement aligns with China’s Belt and Road Initiative, which aims to promote trade and fund infrastructure projects.

BOC’s announcement on its website and RTV Malacañang’s video about the visit shows Chua was present during the signing as a representative of the International Chamber of Commerce Philippines.  It was later reported that the company was included in the $3 billion credit line that the BOC gave to Philippine private corporations during the visit.

PPRPPC stood out because it had no prior track record in the energy industry and had low capitalization. The company was awarded a total of 9 multi-billion hydropower projects, eight of them in the province of Apayao and one in Kalinga. Two of the nine, Gened-1 and Gened-2, cost Php41.65 billion.

Representatives of different Philippine corporations sign a cooperation agreement with the state-owned Bank of China on October 21, 2016, in Beijing, China. Among those signing the agreement is PPRPPC President Allee Lourdes Sun. Photo from Bank of China’s website

Representatives of different Philippine corporations sign a cooperation agreement with the state-owned Bank of China on October 21, 2016, in Beijing, China. Among those signing the agreement is PPRPPC President Allee Lourdes Sun. Photo from Bank of China’s website

Francis C. Chua who represents the International Chamber of Commerce Philippines as its Chairman can be seen during the signing of cooperation agreements between Bank of China and Philippine SMEs. The agreement signing was part of then President Rodrigo Duterte’s state visit to China in October 2016. Photo from Bank of China’s website

Francis C. Chua who represents the International Chamber of Commerce Philippines as its Chairman can be seen during the signing of cooperation agreements between Bank of China and Philippine SMEs. The agreement signing was part of then President Rodrigo Duterte’s state visit to China in October 2016. Photo from Bank of China’s website

Former President Rodrigo Duterte stands beside the Chairman of the Bank of China Tian Guoli during his visit to the bank on Oct. 21, 2016, to witness the signing of several agreements with Philippine corporations. The visit was among the several meetings during his state visit to China in October 2016 which brought home several deals for infrastructure projects and loans. Photo from Bank of China’s website

Former President Rodrigo Duterte stands beside the Chairman of the Bank of China Tian Guoli during his visit to the bank on Oct. 21, 2016, to witness the signing of several agreements with Philippine corporations. The visit was among the several meetings during his state visit to China in October 2016 which brought home several deals for infrastructure projects and loans. Photo from Bank of China’s website

PPRPPC was registered in 2010 with an initial Php10 million capital stock and now has almost Php1 billion in assets according to its financial statement submitted this year.

The DOE stated that it welcomes all private corporations bidding for energy projects, even those without a reputable track record, as long as they are financially capable and meet the requirements.

 "We will look into the technically capable engineers, consultants, and contractors they are hiring for the project. This is part of our evaluation of their application,” said Capongcol.
Department of Energy (DOE) Assistant Secretary Mylene Capongcol

All of PPRPPC’s projects will be built on ancestral lands and must go through the FPIC process to secure the consent of the affected Indigenous communities.

PPRPPC’s original service contract for Gened-1 was for a 600 MW hydropower electric power plant (HEPP), based on the National Power Corporation’s (NAPOCOR) 1987 study funded by the Japan International Cooperation Agency (JICA) on hydropower potentials in Luzon, which identified theApayao-Abulug River as a potential site for a 600 MW hydropower project.

However, the project’s contracts were amended to lower the capacity of the power plants reducing Gened-1 to 150 MW and amending Gened-2 from 50 MW to 250 MW.

Based on Gened-2’s EIS, “due to social and environmental issues, Pan Pacific decided to redesign the hydropower potential by [a] cascade of two plants, the downstream located Gened-1 HPP and the upstream located Gened-2 HPP.”

Gened-1 and 2 had secured their Certification Precondition (CP), a document issued by the NCIP certifying that the company underwent the FPIC process and received the concerned Indigenous community’s consent.

However, members of the community are contesting the CP for the projects citing that the NCIP failed to go through the proper process in obtaining the document.

Item 1 of 2

Despite COVID-19 restrictions, various Isnag Indigenous communities in Kabugao town were gathered by the NCIP for a community consultative assembly in December 2021 as part of the FPIC process for the Gened-2 dam. Photo by Kabugao Youth.

Despite COVID-19 restrictions, various Isnag Indigenous communities in Kabugao town were gathered by the NCIP for a community consultative assembly in December 2021 as part of the FPIC process for the Gened-2 dam. Photo by Kabugao Youth.

Some Isnag residents from Kabugao town expressed their opposition to the proposed 250MW Gened-2 dam by wearing printed shirts during a community assembly for the FPIC process held in December 2021. Photo by Kabugao Youth.

Some Isnag residents from Kabugao town expressed their opposition to the proposed 250MW Gened-2 dam by wearing printed shirts during a community assembly for the FPIC process held in December 2021. Photo by Kabugao Youth.

According to an NCIP official who requested anonymity, before the Commission approved the CP, all issues and concerns relating to the CP application for Gened-1 and 2, which were subject to the CEB's deliberation, were raised and discussed during the deliberation.

“During the deliberation of this specific application, the concerned FPIC team presented the process that was undertaken, along with all their documents to support that the community had given their FPIC for the project. With that, based on the CEB's appreciation and deliberation, they approved the CP,” the NCIP official said.

Two other PPRPPC projects, Calanasan 1 and 2 HEPP, are now undergoing the FPIC process according to the regional office of NCIP in the Cordillera Administrative Region (CAR).

In Kabugao town, where four of the nine dams are set to be built, around 90% of the population belongs to the Indigenous Isnag community.

Estrella Iwag, a 67-year-old Isnag, traveled from Kabugao, Apayao, to Metro Manila in 2022 to voice her community’s opposition to the proposed Gened 1 and 2 dams, which are planned on their ancestral land. Photo by Chantal Eco.

Estrella Iwag, a 67-year-old Isnag, traveled from Kabugao, Apayao, to Metro Manila in 2022 to voice her community’s opposition to the proposed Gened 1 and 2 dams, which are planned on their ancestral land. Photo by Chantal Eco.

Meanwhile, the NCIP regional office in the Cordillera Autonomous Region (CAR), the government agency assigned to facilitate the FPIC process, is giving the renewable energy projects their full support.

 “We are aligned with the government, of course, because of our lack of energy projects. And there are potentials here in the Cordillera, especially with hydro projects. As for us, we ensure that these projects will go through the process of FPIC," said NCIP CAR Regional Director Atty. Roland Calde in an interview.

According to Beverly Longid of the Indigenous people’s group Kalipunan ng Katutubong Mamamayan ng Pilipinas (Katribu), dams are among the most destructive energy projects, having displaced Indigenous peoples from their ancestral lands, particularly in the Cordillera region.

She cited the displacement of Indigenous communities from Benguet province when the Ambuklao and Binga dams were constructed in the 1950s. The displaced Indigenous people were forced to relocate to Nueva Vizcaya province and some to as far as Palawan in the central Philippines.

“Since the Indigenous people will be displaced from their ancestral lands, it [the displacement] will have a direct impact on their way of life as indigenous people,” Longid said. “Our customs, traditions, and culture are rooted in our relationship with the land. Ultimately, this will lead to widespread poverty, and an increase in the number of people without land.”

Displacement of homes and livelihood

In Kabugao town alone, half of its population will be directly affected if these dams are constructed. This means that around 8,000 of Kabugao’s residents will either be displaced from their homes, lose their livelihood, or will experience worsening flooding during the rainy season.

However, information from the DOE’s Renewable Energy Management Bureau and the DENR’s Environmental Management Bureau regarding the exact locations, affected communities, status, and other relevant details about the six dams in Apayao is not available, despite Freedom of Information (FOI) requests submitted to these agencies.

In the contested Memorandum of Agreement (MOA) between the Isnag Indigenous Cultural Community and PPRPPC for the Gened-1 dam, the company identified 277 households in Kabugao that will be displaced. Meanwhile, in Gened-2’s Environmental Impact Statement (EIS), PPRPPC identified 86 houses that will be affected but did not identify how many families will be displaced.

The Gened-1 MOA and Gened-2’s EIS identified more than 260 hectares of agricultural land that the dams will directly affect.

During the 2nd Community Consultative Assembly for Gened-1, held on April 28, 2017, Jimmy Salman, a representative of PPRPPC, said that the provincial government will be responsible for planning the layout, locations, and infrastructure of the resettlement area.

In an interview, Kabugao Vice Mayor Fabulous Tucjang said that while households facing displacement are planned to be relocated within village areas that will not be submerged and compensation will be provided for affected properties and agricultural lands, concrete plans to ensure the implementation of these measures have yet to be presented.

Item 1 of 7

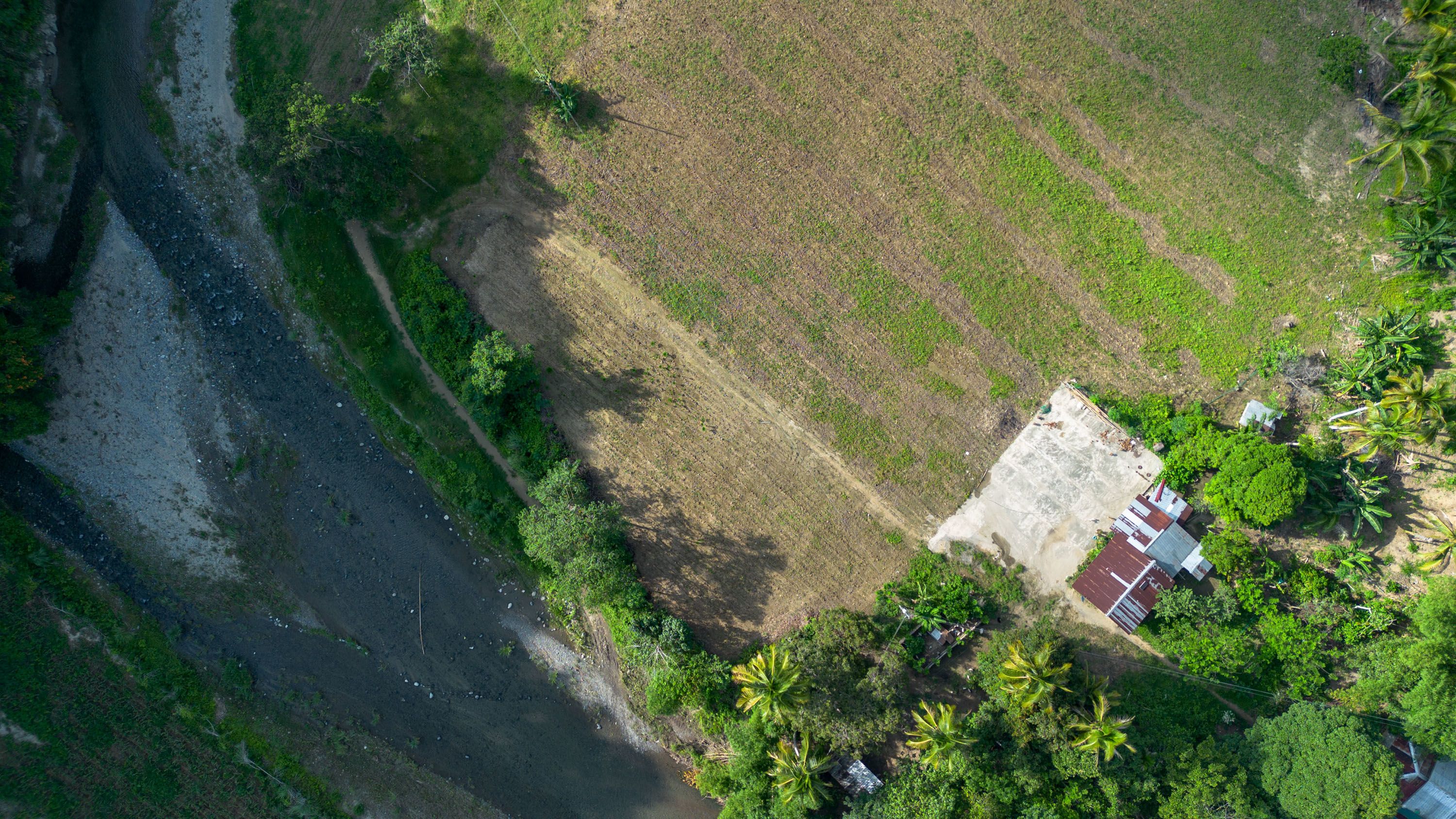

An aerial photo of a low-lying cropland along the Apayao River in Kabugao town. Photo by Chantal Eco

An aerial photo of a low-lying cropland along the Apayao River in Kabugao town. Photo by Chantal Eco

Kabugao Vice Mayor Fabulous Tucjang is among the Isnag Indigenous people actively supporting the construction of hydropower projects in their town. He believes that economic development will follow once the dams are built. Photo by Chantal Eco.

Kabugao Vice Mayor Fabulous Tucjang is among the Isnag Indigenous people actively supporting the construction of hydropower projects in their town. He believes that economic development will follow once the dams are built. Photo by Chantal Eco.

The family of Romeo Allong poses for a photo after visiting the Apayao River, just a few minutes walk away from their house. Their whole family will be displaced once the construction of the Gened-2 dam starts. Photo by Chantal Eco

The family of Romeo Allong poses for a photo after visiting the Apayao River, just a few minutes walk away from their house. Their whole family will be displaced once the construction of the Gened-2 dam starts. Photo by Chantal Eco

Romeo Allong, 62 years old, is the pangat or elder of the Isnag Indigenous community in Sitio Nacagman in Madatag, Kabugao where the Gened-2 dam will be built. Allong said that they have lived there for 10 generations. Photo by Chantal Eco

Romeo Allong, 62 years old, is the pangat or elder of the Isnag Indigenous community in Sitio Nacagman in Madatag, Kabugao where the Gened-2 dam will be built. Allong said that they have lived there for 10 generations. Photo by Chantal Eco

Romeo Dicray, 62 years old, is the current village chief of Madatag in Kabugao town, Apayao province. He is vocal in his opposition to the construction of dams in their town which will directly affect his constituents. Photo by Chantal Eco

Romeo Dicray, 62 years old, is the current village chief of Madatag in Kabugao town, Apayao province. He is vocal in his opposition to the construction of dams in their town which will directly affect his constituents. Photo by Chantal Eco

Livelihood programs, such as providing a fishpond area within the reservoir, are also mentioned but lack detailed planning.

“Once the compensation period begins, that will be the time for us to identify the relocation sites. So when will this start? That's what we don't know yet,” said Tucjang.
Kabugao Vice Mayor Fabulous Tucjang

However, in Sitio Nacagman in Madatag village where the Gened-2 dam will be constructed, residents oppose the construction of the dam, according to Romeo Allong, their pangat or community elder.

Allong, 62, said that all villagers did not consent to the dam as it would wipe out their village, nearby agricultural lands, and burial grounds. Allong’s family has lived for 10 generations in the mountainous area and relies on the upland rice, corn, and vegetable harvest from their kaingin (slash-and-burn farming) and other bounties from the forest like honey from bees which they sell for their daily needs and other expenses.

“If we get relocated, where will we farm? If there's no land, how will we farm? Farming is our primary source of income. Our houses came from our sweat. It would be like starting from scratch again.”
Allong

He added that even if some areas are not submerged, they have been informed that traditional slash-and-burn farming near the watershed area will be prohibited.

Romeo Dicray, 62, the village chief of Madatag, echoed this sentiment regarding the loss of homes and livelihoods in their village.

“For those who will be displaced, where will they be relocated? That’s what we’re asking them (PPRPPC). But we could not get a definite answer.”
Romeo Dicray

He narrated that in one of the assemblies for the Gened-2 that he was able to attend, the proponents were asked what jobs would be given to them if their farmlands were submerged and kaingin would not be allowed around the watershed area. They were not given a definite answer.

 “They said we’ll be employed. But how can most of us be employed when we did not finish school? Employed where? They said in construction. But after the construction is done, what will the people do? Then, nothing,” Dicray lamented.

In a separate phone interview, Dicray confirmed that he, along with many of his constituents, did not sign any resolution giving consent to the project.

“We did not sign anything agreeing to the project, they just did it among themselves,” Dicray said, referring to the former village chief of Madatag, Castor Padeway.

John Anthony Amid, Provincial Indigenous People Mandatory Representative (IPMR) of Apayao, disagrees with the sentiments of locals about their kaingin. He believes that building the dams will bring progress to the province.

“Nowadays, we can see that slash-and-burn farming won't feed your family, and it won't be able to send your children to hospitals or school. The needs now are too diverse.”
John Anthony Amid

Dicray questioned why their community needed to be sacrificed for the sake of progress and expressed concern about the government's promise that no one would be left behind.

LiCAS News tried to reach out to PPRPPC multiple times, but they declined to be interviewed.

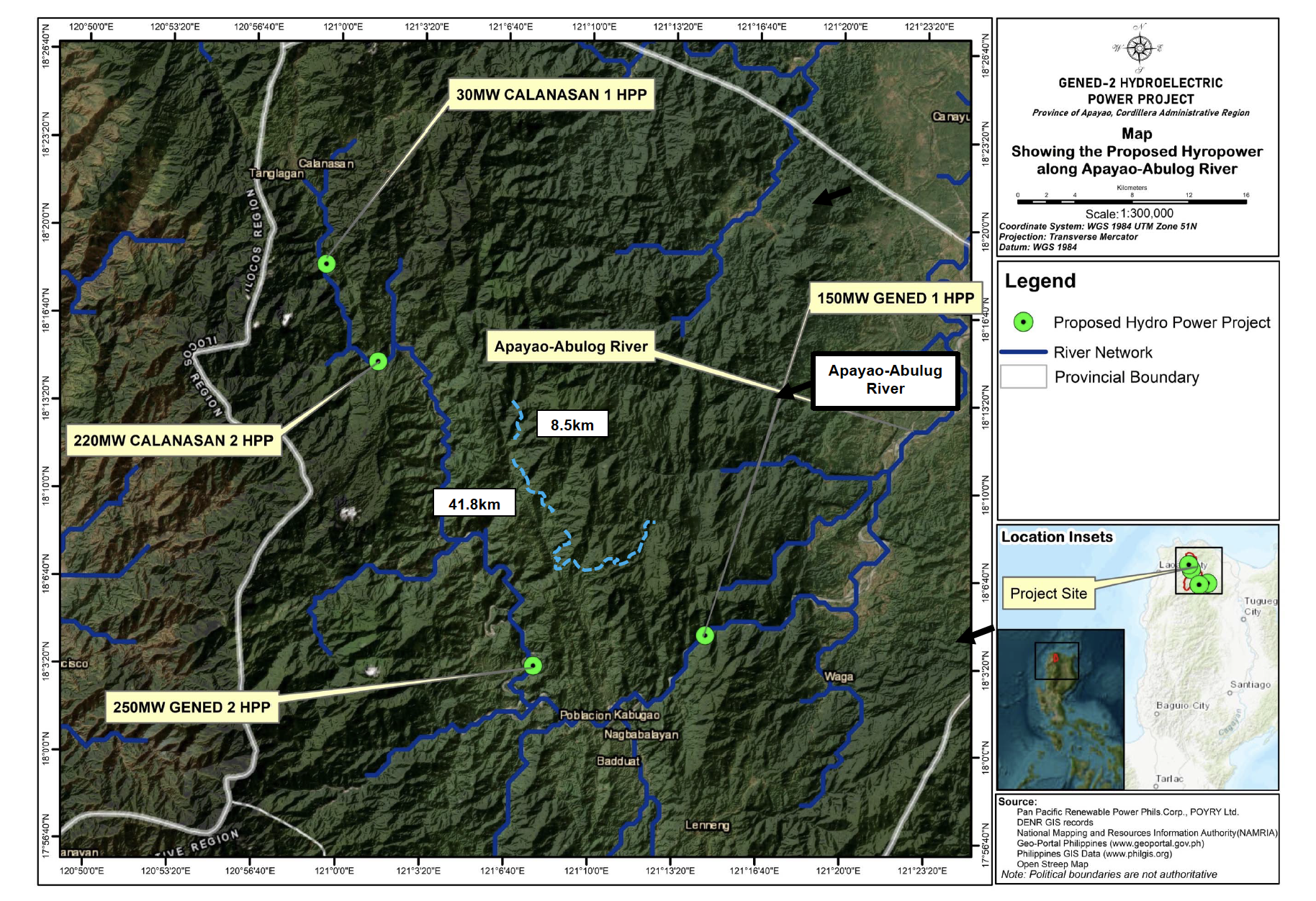

The dams planned along the Apayao-Abulog River will cascade from Calansan 1 and 2 to Gened-2, and then down to Gened-1. However, there is currently no available information regarding the exact locations of the remaining four dams.

The company identified 10 villages in Kabugao town (Waga, Bulu, Magabata, Luttuacan, Poblacion, Laco, Cabetayan, Madatag, Dibagat, and Tuyangan) and 1 in Pudtol (Lt. Balag) that will be directly affected by Gened-1 and 2. This will mean that some areas of the villages will be submerged, including settlements and farmlands, or some areas will be cleared to construct access roads, contractor’s site, diversion tunnel, dam site, and powerhouse among others.

In the coming years, the river where Monique and Princess once played will be too deep to enjoy, and the home they grew up in will be submerged if the Gened-2 dam project near their community proceeds, leaving them uncertain about their future.
